Wind Energy Financing: Key Options and Insights for 2023 Wind project financing in 2023 rarely comes from a single source. Most developers stitch together senior debt, tax equity, sponsor capital, and increasingly, structured equipment financing to get multi-million dollar turbine projects off the ground.

That's easier said than done. High upfront capital costs, complicated risk allocation between lenders and sponsors, and strict eligibility windows for federal tax credits make wind financing a maze for developers and landowners alike. Banks often balk at the soft costs and long payback horizons involved.

This guide breaks down the core financing structures, the tax incentives driving project economics, and how to pick a funding partner that won't walk away when a deal gets complicated.

Key Takeaways

  • Wind projects blend senior debt, tax equity, and sponsor capital — rarely just one source
  • Federal incentives like the PTC and ITC materially improve returns but carry strict construction-start deadlines
  • Banks frequently exclude soft costs and non-standard equipment from financing, creating gaps structured lenders can fill
  • Landowners can collect steady lease income without shouldering development risk

Understanding Wind Energy Financing in the US

Most utility-scale wind projects use project finance, not corporate finance. That means debt and equity are secured against the project's own cash flows and assets through a Special Purpose Vehicle (SPV), non-recourse to the parent company's balance sheet.

The Capital Stack

Industry modeling from Berkeley Lab and NREL points to a debt-to-equity split of around 70-72% debt to 28-30% equity as a common underwriting assumption. The mix shifts with tax credit availability and project-specific risk, per Berkeley Lab's 2024 Land-Based Wind Market Report. This is a modeling sensitivity, not a guaranteed lender requirement.

Where the Money Goes

NREL's 2024 reference project breaks cost down roughly as:

Cost category Approx. share of CapEx
Turbine equipment ~55%
Balance of plant (foundations, electrical, interconnection) ~30%
Soft costs (permitting, engineering, development) ~15%

Wind project capital expenditure breakdown by cost category chart

What Lenders Actually Assess

Before committing capital, lenders dig into:

  • Development risk (permitting, site control, interconnection queue position)
  • Construction risk (completion timeline, cost overruns)
  • Technology risk (turbine performance and warranty terms)
  • Revenue risk (PPA terms, merchant exposure)
  • Operational risk (availability, resource variability)
  • Political/regulatory risk (tax credit stability, local opposition)

Why Traditional Bank Financing Often Falls Short

Banks are built for standardized, repeatable deals. Wind projects rarely are. Grid interconnection costs, extended construction timelines, and soft costs like automation controls or commissioning often fall outside a bank's collateral policy entirely.

CFP's Bank Overflow Desk sees this pattern constantly across large equipment deals. Common reasons banks decline otherwise solid projects include:

  • The deal exceeds internal lending authority or hold limits
  • Specialized or unfamiliar equipment technology
  • Extended construction/installation timelines
  • Soft costs excluded from collateral policy
  • Project leverage outside internal guidelines

Debt Financing Structures for Wind Projects

Wind project debt takes different forms at each stage of the lifecycle.

  • Development loans: fund early-stage permitting, studies, and land control
  • Construction loans: cover the build phase, drawn against milestones
  • Permanent/term loans: replace construction debt once the project reaches commercial operation

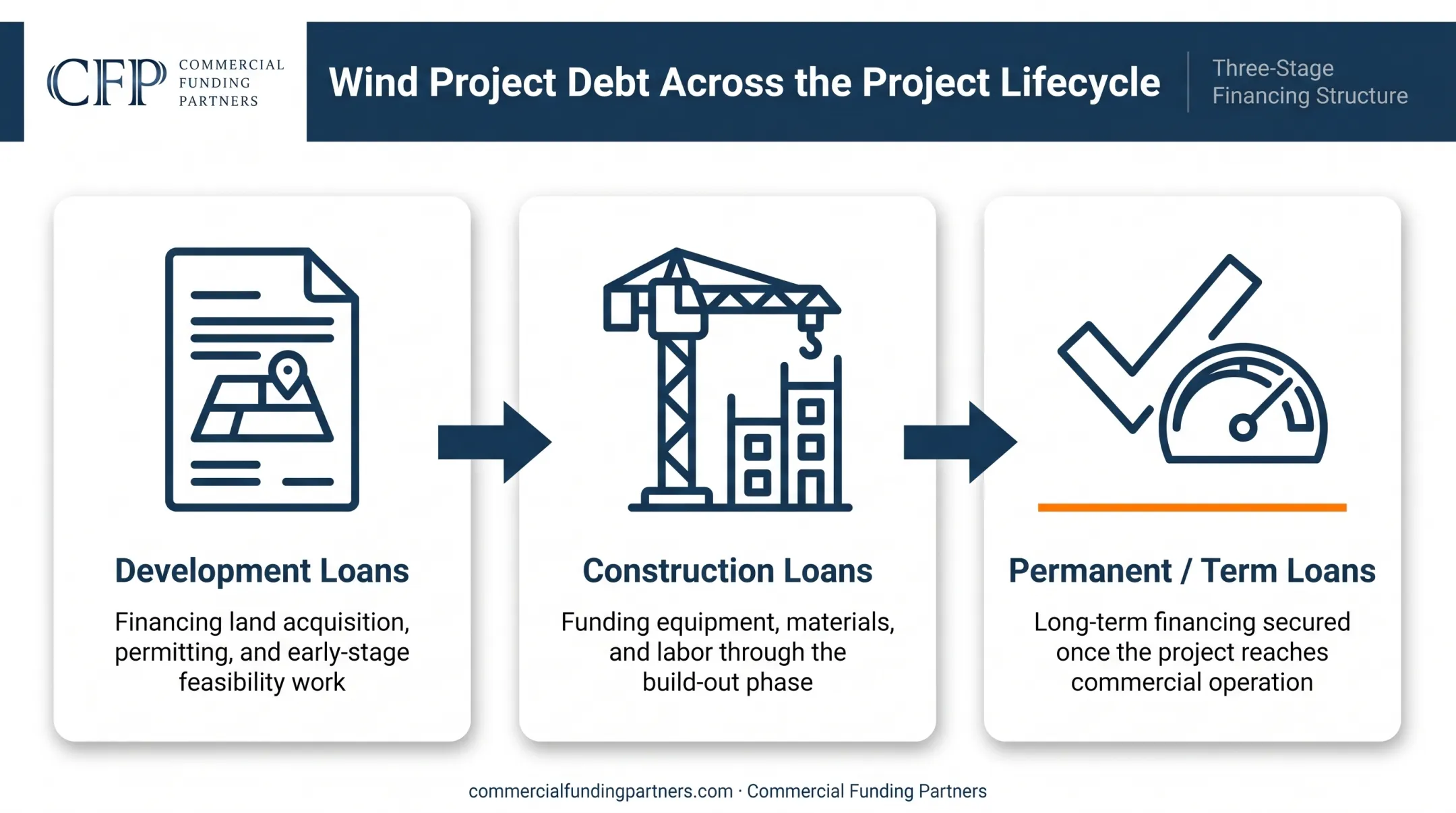

Wind project debt lifecycle stages from development to permanent loans

Back-Leverage Debt

Rather than lending directly against project assets, many sponsors use back-leverage debt, secured by the sponsor's cash-equity interest in the tax-equity partnership rather than the project itself. This protects tax equity investors' priority claim on project cash flows and assets.

The structure is more complex, but it lets sponsors access liquidity without disturbing the tax-equity arrangement, as outlined in ACORE's risk profile analysis.

DSCR Benchmarks

Public rating data gives a useful reference point. S&P's recent wind project ratings show minimum Debt Service Coverage Ratios around 1.32x to 1.36x, compared to solar comparators closer to 1.44x-1.57x (S&P Global's Continental Wind rating action).

These are project-specific examples, not universal thresholds. Still, they signal that wind debt sizing leans conservative given resource and availability variability.

Filling the Gap Banks Won't Cover

Structured capital covers what traditional lenders leave out. CFP finances non-admitted assets and soft costs banks typically exclude, including software, engineering, controls, installation labor, and automation integration, often up to 100% of eligible project costs.

For projects already declined elsewhere, CFP's Bank Overflow Desk re-evaluates the deal from scratch rather than accepting a prior lender's conclusion.

Tax Equity and Federal Incentives Driving Wind Financing

Federal tax credits remain the single biggest lever on wind project economics. Most sponsors monetize them through tax equity rather than on their own tax returns.

PTC vs. ITC

  • Production Tax Credit (PTC): Full Section 45 rate near 3.0 cents/kWh for 2025, or about 0.6 cents/kWh without labor compliance (IRS inflation adjustment)
  • Investment Tax Credit (ITC): Base credit of 6%, rising to 30% with prevailing wage and apprenticeship compliance, plus potential 10-point bonuses for domestic content or energy-community siting

Developers can't claim both on the same facility. The choice depends on resource quality and expected capacity factor. Lower-resource sites sometimes favor the ITC's upfront certainty over the PTC's production-linked payout.

The Partnership Flip

In a typical partnership flip structure, a tax equity investor takes a large initial allocation of tax benefits and cash flow. Once they hit a target return, allocations "flip" back to the sponsor, who then holds the majority long-term cash flow position.

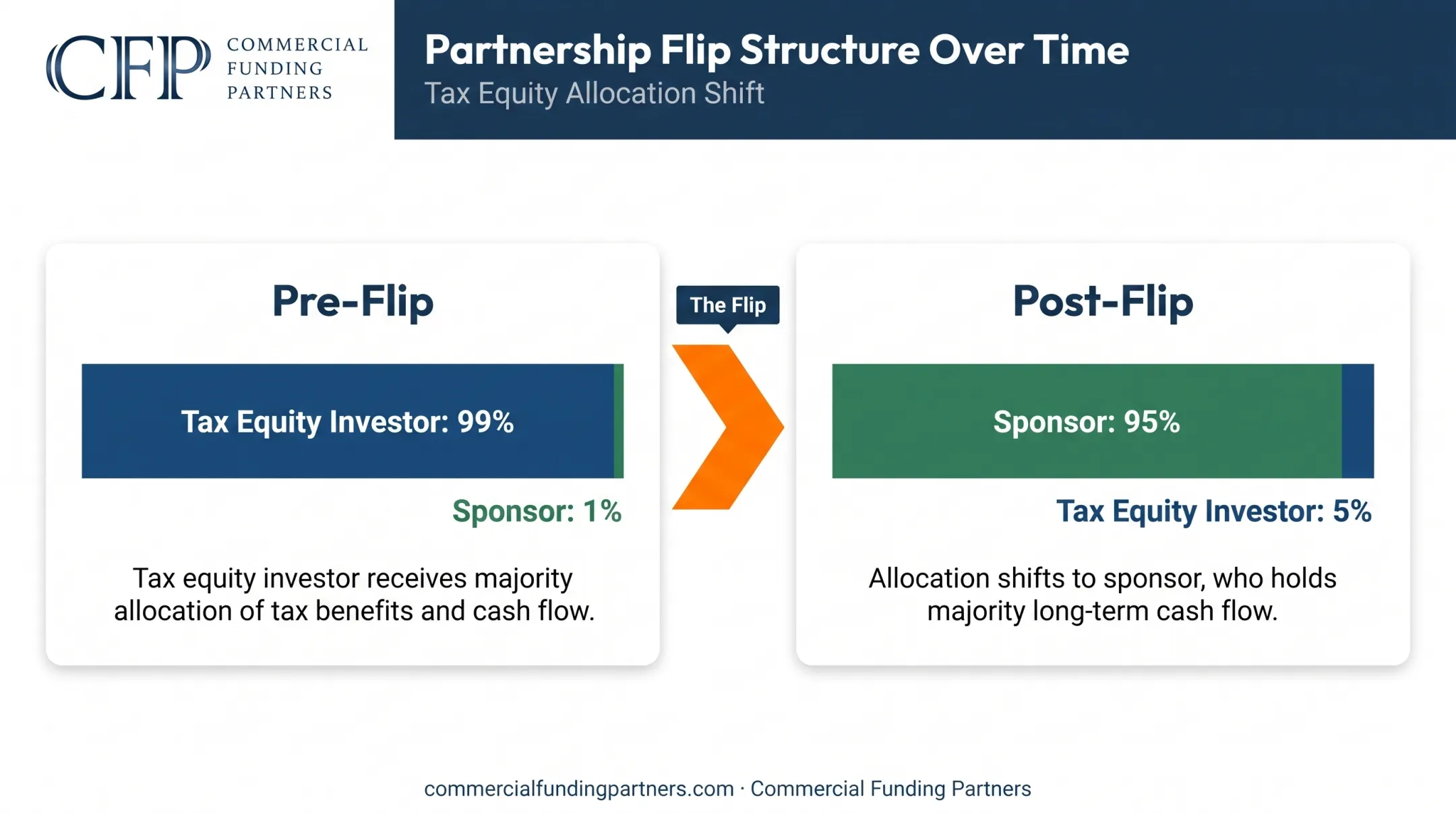

Partnership flip structure diagram showing tax equity investor cash flow allocation shift

Stacking Additional Benefits

State RPS/REC markets create demand for Renewable Energy Certificates and add incremental revenue—recent regional examples run roughly $35–$40/MWh.

Accelerated depreciation (MACRS) uses five-year schedules that stack with PTC or ITC and further improve after-tax returns.

Watch the Dates

Construction-timing rules shifted under recent guidance. The key post-2025 change applies to wind facilities beginning construction after July 4, 2026, with a placed-in-service cutoff for the 45Y credit after December 31, 2027 (IRS Notice 2025-42).

December 31, 2025 is a separate deadline tied to prohibited-foreign-entity supply chain rules, not a universal construction cutoff. Get a written eligibility opinion before treating either date as controlling for your project.

Alternative Revenue and Financing Paths

Power Purchase Agreements and Merchant Risk

Long-term PPAs give lenders the revenue certainty they need to size debt confidently. Recent pricing trends show upward pressure: LevelTen's wind PPA index rose roughly 5% quarter-over-quarter in Q3 2025, up 14% year-over-year. Locking favorable PPA terms early matters more in this market. Any merchant tail exposure still needs careful underwriting for basis, curtailment, and shape risk.

Landowner Leasing and Passive Income

For landowners who want wind revenue without taking development risk, common structures include:

  • Fixed lease payments
  • Per-turbine royalties
  • Revenue-sharing arrangements

Terms vary widely by region, turbine size, and deal structure. There is no single standard rate, so comparable local agreements matter more than any headline number.

Self-Financing and Repowering

When balance sheets are strong and turbine counts stay modest, landowners and co-ops may self-finance smaller projects and avoid third-party debt entirely.

Repowering (replacing older turbines with larger-rotor, higher-output models on an existing site) is a separate capital event. It requires re-underwriting interconnection capacity, permitting, and tax basis—not just a turbine swap.

Choosing the Right Financing Partner

Complex wind deals need lenders who understand equipment risk, not just balance sheets. A relationship-driven approach matters when a project has non-standard soft costs, extended construction timelines, or specialized turbine technology.

For those deals, look for a partner built for equipment complexity—not only clean balance sheets. CFP operates as a direct lender and institutional capital source for large equipment and structured capital needs from $250,000 to $300 million, spanning power generation and renewable energy projects. That includes:

  • Flexible lease structures (capital, operating, FMV, sale-leaseback)
  • Milestone and progress-payment funding for extended builds, including deposits, engineering, fabrication, installation, and commissioning
  • A free Second Opinion Review for projects declined or poorly priced elsewhere

CFP has funded renewable and power-generation infrastructure directly, including turbine equipment and balance-of-plant needs such as cabling, site work, and permitting-related costs. That work includes a $3.5 million power-plant financing structured on a 48-month lease after banks stepped back, and a $6 million solar farm deployment.

Renewable energy power plant financing project with turbine and solar installation

What to look for in a financing partner

  • Direct experience in your specific equipment category
  • Response speed (same-day preliminary reviews are a good benchmark)
  • Willingness to finance both hard equipment and soft costs
  • A track record with projects previously declined elsewhere

Frequently Asked Questions

Can wind energy projects pay for themselves without subsidies?

Some large-scale projects with strong PPAs and excellent wind resources can achieve viable returns without subsidies, though the payback timeline lengthens. Site quality and contracted revenue terms matter more than subsidy status alone.

How much do farmers get paid to host wind turbines per month?

Lease payments vary significantly by region, turbine size, and contract structure. There's no universal per-turbine or per-acre standard. Payments may be fixed, per-MW, or revenue-share based, so comparing local agreements is essential.

What federal tax credits are available for wind energy projects?

The Production Tax Credit (around 3.0 cents/kWh at the full rate for 2025) and the Investment Tax Credit (up to 30% with labor compliance, plus bonus adders) are the two primary options. Construction-start timing rules changed after mid-2026, so confirm current eligibility before modeling returns.

How long does it take to see ROI on a wind energy project?

Timelines vary widely by scale, financing structure, and resource quality. There's no single verified industry-wide figure. Model your project-specific IRR, debt tenor, and tax treatment rather than relying on a generic benchmark.

What is back-leverage debt and why is it used in wind financing?

Back-leverage debt sits above the project company, secured by the sponsor's junior interest in the tax-equity partnership rather than project assets directly. This protects the tax equity investor's priority claim while still giving sponsors access to liquidity.

Can equipment financing cover turbines and balance-of-plant costs?

Yes. Structured equipment financing can fund turbines, foundations, and soft costs (such as automation controls, installation labor, and commissioning) that traditional bank loans often exclude from collateral.
